Lake Alfred at a glance
Lake Alfred is a Polk County city with its own Community Development permit desk on Accela, and home to the UF/IFAS Citrus Research and Education Center.
Inspections need a request by 2 pm for the next day and a utility account first, so the pour date follows the paperwork. Construction traffic compacts sand and can leave standing water, so the pad is graded to shed it.
Permit office: City of Lake Alfred Community Development (Building Permits) · official site Accela permitting; registered contractor or homestead owner-builder may apply; sealed plans and a site plan for sheds; recorded Notice of Commencement over $2,500, copy to the city over $5,000; no same-day inspections (2 pm cutoff); utility account before any inspection.
Setting a pour date around the 2 pm inspection cutoff
The city's Building Permits page says inspections cannot be same day, with a 2 pm cutoff to book the next day. It also says new construction needs a utility account before any inspection. Neither rule is hard. Both can cost you a truck if nobody plans for them.

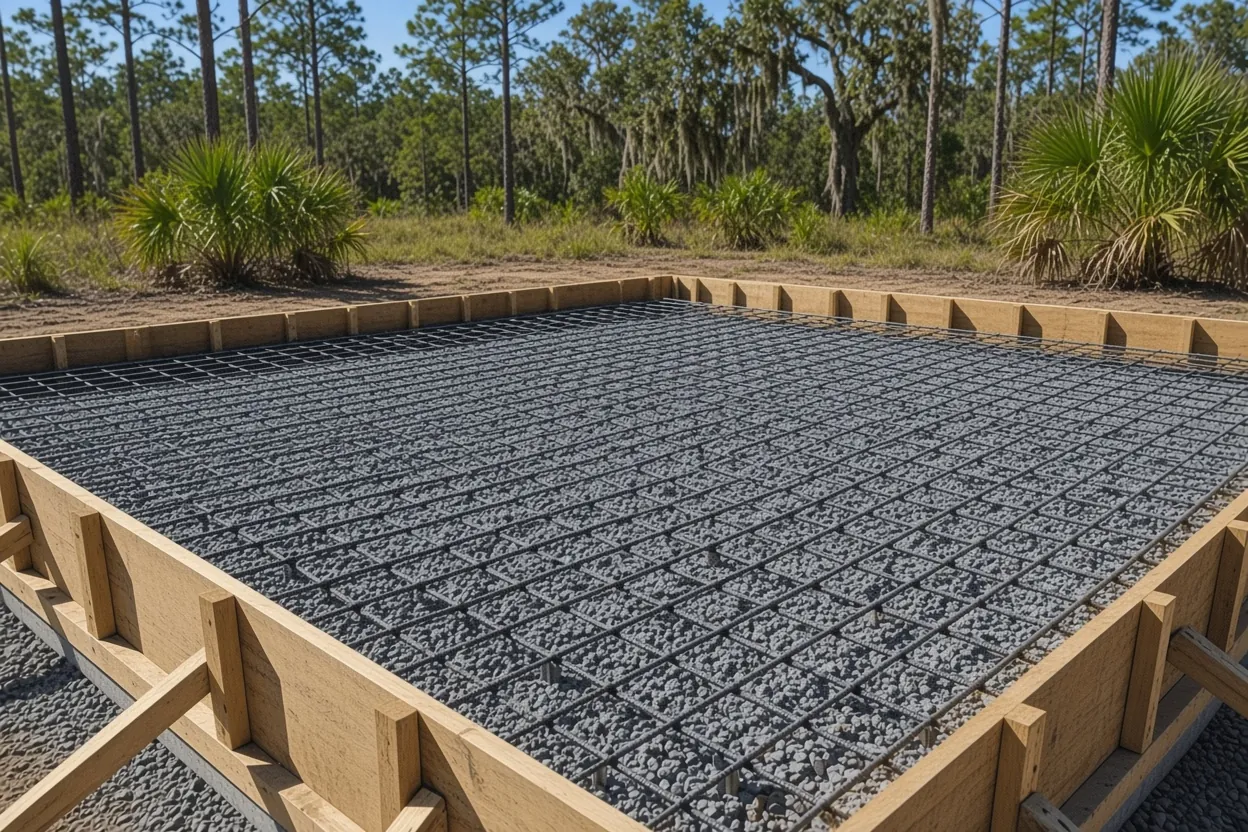

So we schedule backward from the pour. Pad, treatment, vapor retarder and steel are done the day before inspection, and the permit holder books it before 2 pm. The inspection happens the next day, and the ready-mix is ordered for the morning after a pass, not before. Open the utility account when the permit issues, not when the forms are up. Miss the cutoff and the inspection slides a day, and the truck slides with it.

Who can file: a registered contractor or a homestead owner
Lake Alfred takes permits through Accela, and its page names two kinds of applicants: a contractor whose state license is registered in the city's Accela system, or the owner of homesteaded property acting as their own contractor. If the barn or shop is going on land that is not your homestead, plan on a registered contractor pulling the permit.
That choice also decides who books the inspections, since the permit holder makes those calls. If you pull it yourself, you will be the one watching the 2 pm cutoff. If your builder holds it, we coordinate the pour date with them. Either way, tell us at the first visit who is filing so the quote and the schedule match. A post-frame builder who sets posts before our pour, a choice covered in our guide on pouring before or after the pole barn, also needs to know whose name is on the permit card.

What It Costs
Our typical ranges for Lake Alfred jobs. A 36 by 48 barn floor is 1,728 sq ft, so at $7 to $12 per sq ft it runs about $12,096 to $20,736 before extra fill.
| Job | Per sq ft | Typical project | What moves the price |
|---|---|---|---|
| Pole barn slab | $7 to $12 | $8,500 to $15,000 | 30x40, 4 to 6 in. reinforced, before or after the frame |
| Barndominium foundation | $10 to $16 | $20,000 to $40,000+ | Monolithic with thickened edges, plumbing and electrical sleeves |
| Metal or steel building foundation | $8 to $14 | $15,000 to $80,000+ | Engineered piers or thickened edge, anchor-bolt template |
| Agricultural or equipment slab | $6 to $11 | $6,000 to $40,000+ | Equipment loads, pad height |
| Horse barn or equestrian slab | $7 to $13 | $8,000 to $35,000 | Aisle finish, drains, stall layout |
| Detached garage or workshop slab | $7 to $12 | $4,500 to $15,000 | Thickened edges, apron, lift area |
| Aircraft hangar slab | $10 to $18 | $36,000 to $120,000+ | 6 to 8 in. reinforced, door-track footing |
Extra fill, a pump for a long reach and engineered heavy-load details can add to these numbers. You get a free written estimate after we see the site.
Sealed plans, a site plan and the Notice of Commencement
For sheds, the city asks for building plans sealed by a Florida architect or engineer and a site plan that shows dimensions and setbacks. For a barn or shop, have the engineer's sealed foundation sheet in hand before you apply. Florida requires a recorded Notice of Commencement on jobs over $2,500, and over $5,000 the city needs a copy before the first inspection. Any barn or barndo slab at our ranges clears both, and a small shop slab can land close to the $5,000 line, so check the number on your written quote.

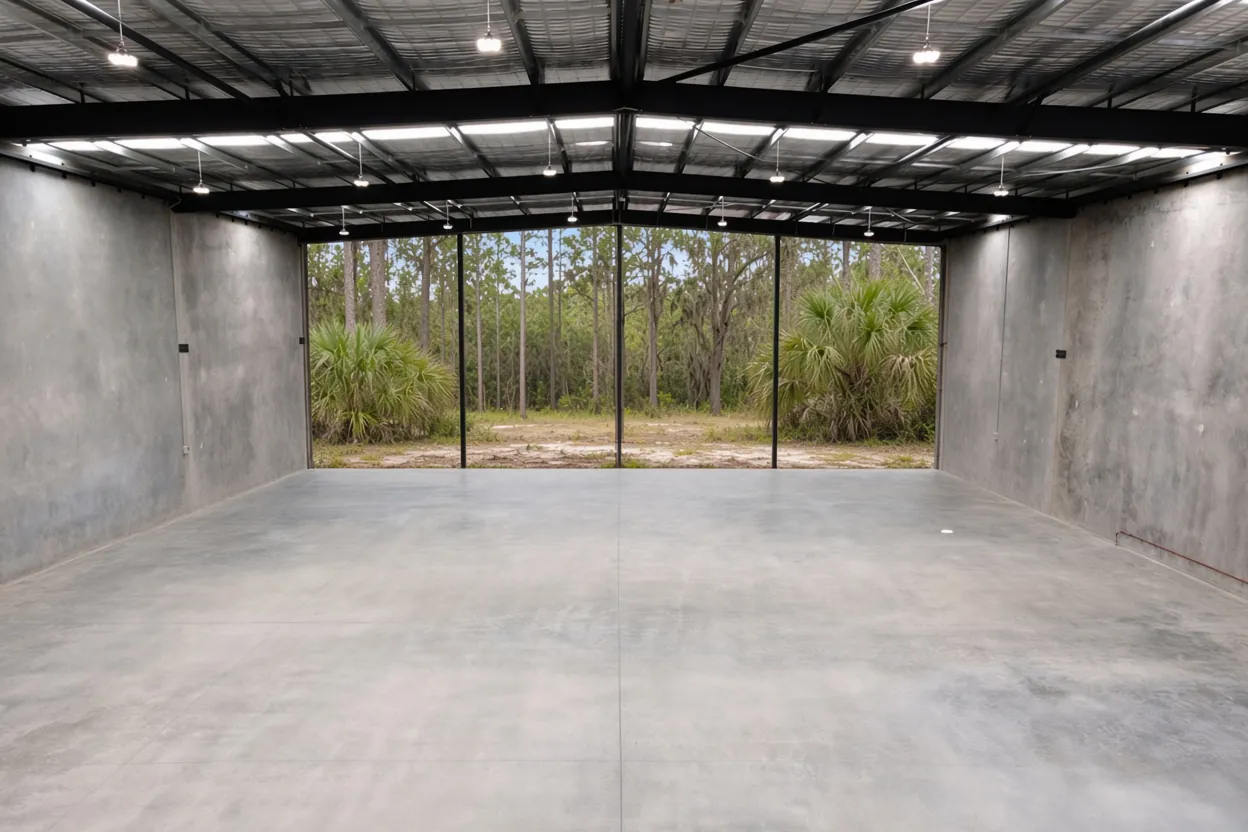

We work from the sealed sheet, not around it. Thickness, steel, thickened edges and anchor bolts come straight off the drawing, and if something on it looks wrong for the ground we see, we raise it with your engineer before the pour, not after. Bring the site plan to the visit and we will check that the forms can land where the setbacks say, with room for a truck to reach them.

How the Job Goes
Site visit
We walk the Lake Alfred pad, check the truck route and ask who is holding the permit.
Line-by-line quote
Fill, steel, thickness and joints come straight off the sealed sheet.
Permit and utility account
The permit holder files through Accela, records the Notice and opens the utility account early.
Inspection, then pour

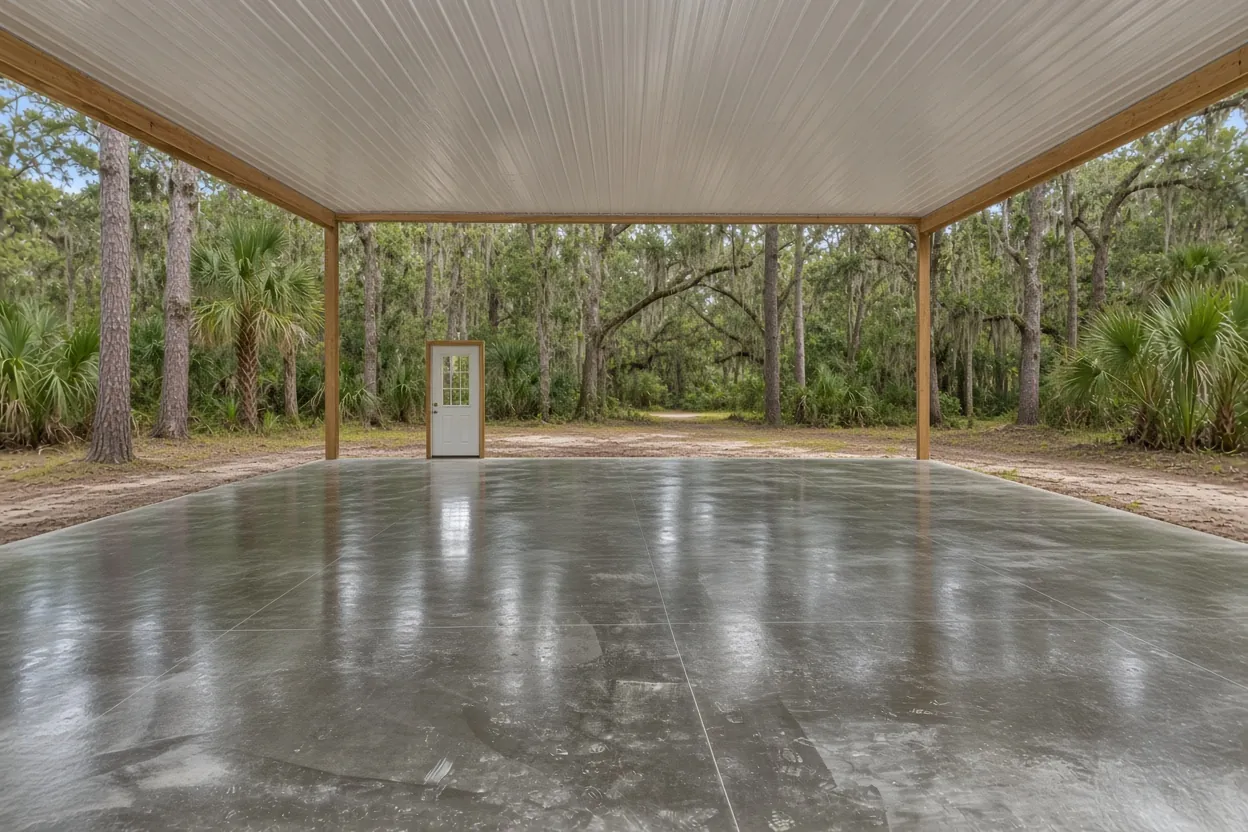

The inspection is booked before 2 pm, and the truck is ordered only after it passes.
The exemption form that does not cover a building slab
Lake Alfred posts a Permit Exemption Request form, and it is easy to read it as covering a barn floor. It does not. The form covers work under $7,500 on a single-family home that is not structural, electrical, mechanical, plumbing or gas, plus voluntary flood panels. A slab that carries a building is structural, and a new barn is not repair work on a house.
Florida's farm-building exemption under s. 604.50 is a separate thing with its own test, explained in our farm building exemption guide. The city's permit page does not lay out a farm-building process, so if you plan to claim it inside city limits, ask Community Development how it handles that before you count on skipping review. The same page points to the city's floodplain rules and FEMA flood maps, which the farm exemption never waives.
Two permit offices with a Lake Alfred address
Lake Alfred is its own permit agency on the Polk County Property Appraiser's list, with Community Development on North Lake Shore Way. The Polk County Building Division also keeps an office in Lake Alfred, alongside its main desk in Bartow. That county office handles unincorporated parcels, not city ones.
The two are easy to mix up. A parcel inside city limits files with the city, even if the county counter is closer. A parcel outside every town files with the county, through the Accela Citizens Portal, under Polk's rules: slabs that support a structure need a permit and must meet setbacks from property lines and easements. Check the parcel on the Property Appraiser site before you pick a counter, and before anyone draws a plan for the wrong one.
Packing sheds and equipment barns near the citrus research center
The UF/IFAS Citrus Research and Education Center sits on Experiment Station Road in Lake Alfred, and Polk County still counts citrus, cattle and agriculture among the industries that carry its economy. A packing shed, equipment barn or pump house on working land is the kind of building we pour for.
A barn on working grove land gets a lot of traffic before it ever gets a floor: trucks, trailers and the frame crew all cross the same ground. The Polk County Water Atlas notes that compacted soil lets less rain soak in, so standing water can show up after a storm on ground that used to drain. We plan the truck route away from where the swale has to go, and we grade the finished pad so water leaves the slab edge instead of pooling against it. Check the parcel on the NRCS Web Soil Survey before the visit. For the building itself, see pole barn slabs in Lake Alfred, barndominium foundations in Lake Alfred or metal building foundations in Lake Alfred, plus our equipment slab and horse barn slab pages.
Lake Alfred job details we ask for
- Parcel ID, so city versus county is settled first.
- Whether the land is your homestead, and who will hold the permit.
- Utility account status for the site.
- The engineer's sealed foundation sheet and the site plan with setbacks.
- Building size, door sizes and what will roll across the floor.
- Your frame crew's arrival date, so the pour and inspection fit ahead of it.
Call (863) 269-3083 to book the free on-site estimate. We also pour in Winter Haven, Auburndale, Haines City, Lake Hamilton and Cypress Gardens.
Questions We Get
What time do I have to request a Lake Alfred inspection?
Do I need a Lake Alfred utility account before the slab is inspected?
Can I pull a Lake Alfred permit myself as an owner-builder?
Does Lake Alfred's Permit Exemption Request cover a barn slab?
The county has an office in Lake Alfred. Do I file there?
Does Lake Alfred want sealed plans for a small building slab?
Sources we used
- Building Permits, City of Lake Alfred
- Building Permit Exemption Request, City of Lake Alfred
- Permit Agencies, Polk County Property Appraiser
- Building Permitting, Polk County Building Division
- Citrus Research and Education Center (CREC), UF/IFAS
- Learn More: Soils, Polk County Water Atlas (USF Water Institute)
- Florida Statutes s. 604.50 Nonresidential farm buildings, Florida Legislature (Online Sunshine)
- About Polk County, Polk County
