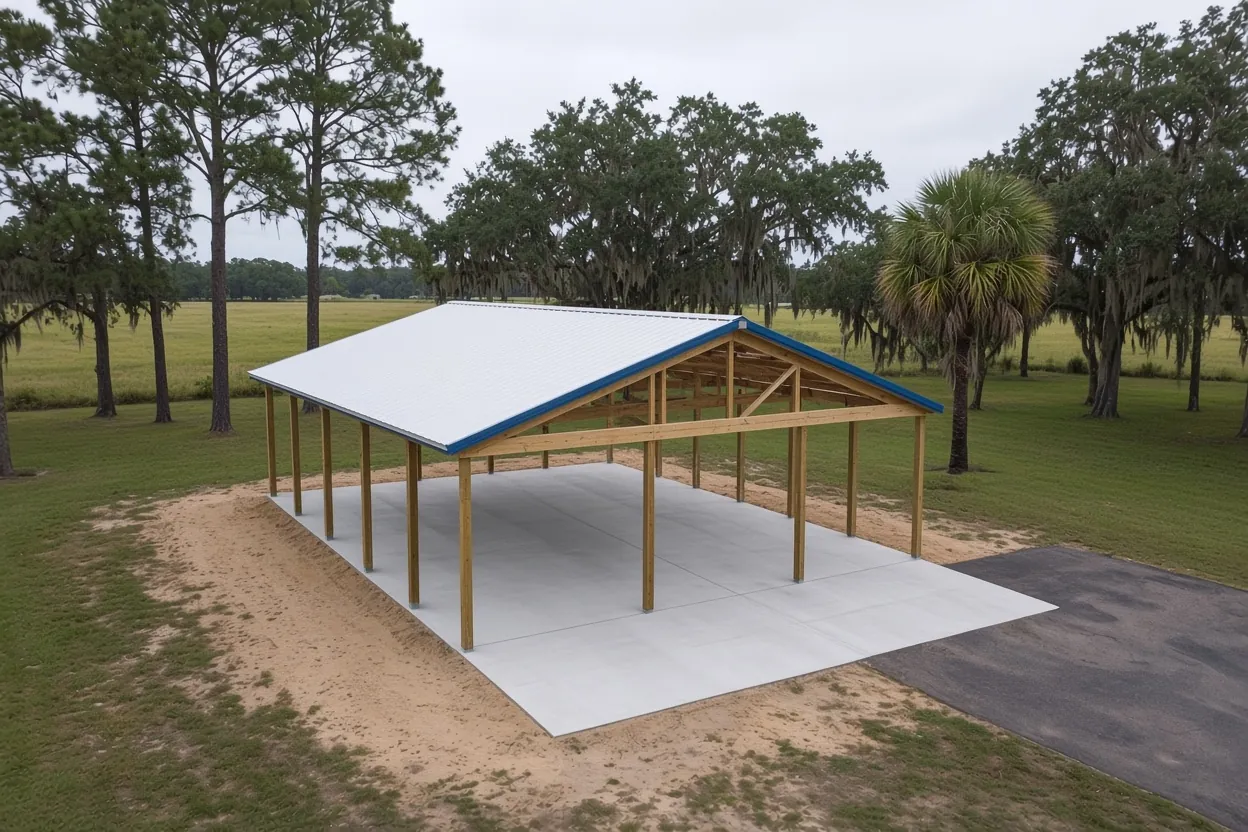

Finished pole barn slab on a raised sand pad on a Davenport, Polk County lot

Pole Barns · Polk County

Pole Barn Slabs in Davenport, FL

Barn floors on raised pads for Davenport lots, with fill, post holes and pour order planned before the kit arrives.

  • Free on-site estimate
  • Written quote within 48 hours
  • Engineer's plans followed to the letter

Request a Free Estimate

Tell us what you're building. We'll call to set up a site visit.

No obligation. We'll only use your number to talk about this project.

Got it. Thank you.

We'll call you shortly to set up a site visit. Need us sooner? Call (863) 269-3083.

The short answer

A pole barn slab in Davenport, FL on a lot in a Special Flood Hazard Area may need a pad built up with fill to reach the floor height on your plans, and the city wants an elevation certificate before the slab inspection, so settle the pad height before the first post hole is dug. Concrete Barn Slabs Polk County pours these barn floors at $7 to $12 per sq ft, about $8,500 to $15,000 for a 30x40 floor 4 to 6 inches thick.

A raised barn pad and the order Davenport's checklist sets

Davenport's Building & Planning Department issues building permits inside the city and also runs its floodplain program. Its submission checklist asks for an elevation certificate before the slab inspection on any property in a Special Flood Hazard Area. For a pole barn slab, that means the floor height on your plans sets everything after it: how much fill goes in, how deep the posts sit, and when the surveyor comes out.

This page covers that chain for barns. Our pole barn slab page explains the job countywide, and the before-or-after-the-posts guide compares the two pour orders in full. For every slab type we pour in town, see our Davenport concrete slab page. If you're planning a house on the same acreage, the Davenport barndominium foundation page covers that slab on its own.

Surveyor's grade stakes on a low lot planned for a pole barn in Davenport
Grade stakes mark the floor height.

Posts set into built-up fill: what the sealed sheet has to say

On a flat, dry lot, a pole barn's posts go into native ground and the pole barn floor follows. On a raised Davenport pad, the fill comes first, and that raises questions the plans need to answer before anyone digs:

  • Embedment from which grade? Post depth on the sealed sheet is measured from a finished grade. Ask the engineer whether that's the top of the new pad or the original ground.
  • Collars or no collars. If the plans show concrete collars around the posts, we pour them to the depth and diameter drawn, and the fill around them has to be compacted, not dumped.
  • Fill depth. Florida's residential code caps fill under a slab at 24 inches of clean sand or gravel unless the building official approves more. When a shallow foundation sits on compacted fill deeper than 12 inches, the building code calls for a geotechnical investigation. Ask your engineer how that applies to the post footings.
  • Who sets the posts. Settle that in your contracts, whether it's the barn builder or the kit erector. Whoever it is, we need the post layout in writing so the slab edge, door openings and any anchor details line up.

Get those answers before the fill is ordered. A post set a few inches shallow in a raised pad is a hard fix once the pole barn slab is poured around it.

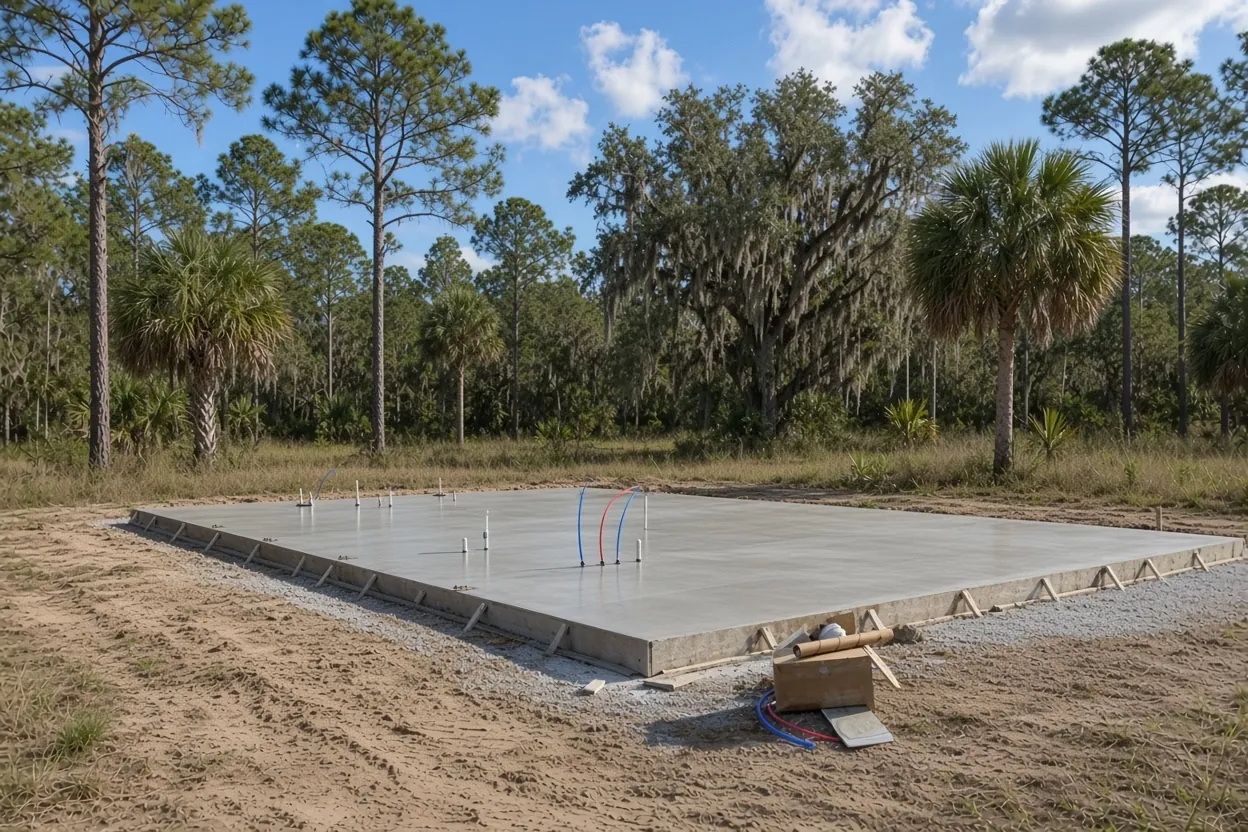

Pole barn posts standing in a compacted fill pad near Davenport before the floor pour
Posts set in a built-up pad.

What It Costs

Our ranges for pole barn floors around Davenport. Pad height and fill move the final number most.

JobPer sq ftTypical projectWhat moves the price
Pole barn slab, 4 to 6 in. reinforced$7 to $12$8,500 to $15,000 (30x40)Fill depth, taller forms, pump, post collars
Shed or storage building slab$7 to $12$1,800 to $5,000Size and pad build-up
Agricultural or equipment slab$6 to $11$6,000 to $40,000+Equipment loads, pad height

A 30x40 is 1,200 sq ft, or $8,400 to $14,400 at our per-foot range before fill. Your price comes in a free written estimate after we see the site.

Davenport paperwork for a barn floor, and where the county takes over

Inside city limits, the Davenport permit submission checklist wants a signed, notarized application, a survey or plot plan with setbacks marked, and a recorded Notice of Commencement on permits of $2,500 or more. A pole barn floor at our prices clears that line. State law (s. 713.13) also has the owner record the Notice before work begins on any job over $2,500, so get it recorded before pad work starts.

A Davenport mailing address can still be county land. Outside city limits and every other town, the Polk County Building Division in Bartow issues the permit, and the county's permit lookup is the same viewer Davenport uses. Check the parcel on the Polk County Property Appraiser site before you file.

A working farm barn may qualify for the state exemption under s. 604.50, but the statute keeps floodplain rules in force. So a raised pad on a flood-zone lot still has to meet the floor height, exempt or not. Our farm building exemption guide lays out the tests, and Davenport Building & Planning can tell you how it treats a farm barn inside the city.

Rural Davenport parcel with a barn pad and site plan stakes at the setback line
Setback stakes on a barn parcel.

How the Job Goes

  1. Shoot the grade

    We compare the plan's floor height with the ground at each corner of the footprint.

  2. Price the build-up

    Fill, compaction, forms and any pump get separate lines on the written quote.

  3. Raise and prep the pad

    Fill goes in by lift and gets compacted, posts and collars go in, then termite treatment, poly and steel.

  4. Inspect, pour, cure

    With the elevation certificate in and the inspection passed, we pour, cut joints and keep the slab wet.

Pour day on a pad that sits above the yard

A raised pad changes how the truck gets to a pole barn slab. Fresh fill at the pad edge may not carry a loaded mixer, so we either build a compacted ramp to one side or set a pump on firm ground and reach in. Forms run taller on the low side to hold the slab edge, and the grade around the pad gets shaped so storm water runs off and away instead of cutting into the fill.

Rain is the other risk. The National Weather Service puts West Central Florida's rainy season at May 25 to October 10. A downpour on a bare sand pad can rut the surface and wash out an edge the day before a pour, so we check the pad again the morning of and reset what needs it. Compacted soil also takes in water slowly, which the Polk County Water Atlas ties to standing water after storms, so we want the pad crowned before the poly goes down.

After the pour, the floor cures wet for several days before the framing crew sets anything heavy on it. Your builder should have that date before the truck is booked.

What to have on the table at the Davenport site walk

  • Your parcel number, so we know whether Davenport or Polk County holds the permit.
  • The flood zone for the lot and the finished floor height on your plans.
  • Your surveyor's name, so the elevation certificate is booked before the slab inspection.
  • The builder's post layout, post depth and any collar details, in writing.
  • Door sizes and where trailers or equipment come in.
  • Where a truck or pump can stand on firm ground near the pad.

Other Polk towns where we pour pole barn slabs: Haines City, Winter Haven, Lake Wales and Lakeland. For a steel frame, see metal building foundations in Davenport.

Questions We Get

Does my Davenport farm barn still need an elevation certificate?
If the lot is in a Special Flood Hazard Area, plan on it. Florida's farm-building exemption keeps floodplain rules in force, and Davenport's checklist wants the certificate before the slab inspection. Ask Davenport Building & Planning how it applies to your parcel, then book your surveyor once the forms are set.
Should the posts go in before or after the fill on a raised Davenport pad?
Your engineer decides. With the fill placed and compacted first, post depth is measured from a known grade; with posts first, the sheet has to say how fill goes in around them. Ask whether the embedment on the sealed sheet starts at the new pad or the old ground. We need that answer, and the post layout, before we quote the floor.
How high can you build a barn pad with fill in Davenport?
Florida's residential code caps fill under a slab at 24 inches of clean sand or gravel unless the building official approves more. Past 12 inches under a shallow foundation, the building code calls for a geotechnical investigation. Tell us the plan's floor height and we measure how far that sits above your ground.
Can a mixer truck back onto a freshly filled barn pad in Davenport?
Not onto loose edges. Fresh fill needs compacting before it carries a loaded truck, and even then the pad edge is the weak spot. We build a compacted ramp or set a pump on firm ground and reach the pad from there. Whichever we use is priced on the written quote.
My Davenport barn kit shows concrete post collars. Do you pour those?
Yes. We pour collars to the depth and diameter drawn on your plans, and the fill around them gets compacted, not dumped. If your builder sets the posts, we coordinate the date with them. Send us the collar detail before the visit so it's in the quote.
Will a summer storm wash out a raised barn pad before the Davenport pour?
It can rut the surface or cut an edge. The rainy season runs May 25 to October 10, so we grade the pad to shed water, check it again the morning of the pour and fix what the rain moved. If storms are on top of us, we move the pour date with you.

Sources we used

Other Slabs We Pour

Pole Barn Slabs

Floors and footings for post-frame and pole barns, poured before the build or inside the posts after.

Learn more →

Barndominium Foundations

Monolithic foundations for barndominiums: termite-treated, vapor-barriered, and roughed-in to plan.

Learn more →

Shed & Storage Building Slabs

Square, level pads for sheds, prefab storage buildings, and small shops, ready to anchor for Florida wind.

Learn more →

Aircraft Hangar Slabs

Heavy-reinforced hangar floors and door-track footings for private, airpark, and T-hangar builds.

Learn more →

Warehouse & Commercial Slabs

Warehouse, shop, and light-commercial floors with joint plans and finishes built for forklifts and racking.

Learn more →

Metal & Steel Building Foundations

Engineered slabs and pier footings with anchor bolts set to the building manufacturer's drawings.

Learn more →

Detached Garage & Workshop Slabs

Garage and shop slabs with thickened edges, apron, and lift-ready reinforcement where you need it.

Learn more →

RV, Boat & Carport Pads

Long, thick pads for motorhomes, fifth-wheels, boats, and carports, with the approach graded so you can back in clean.

Learn more →

Horse Barn & Equestrian Slabs

Aisles, wash racks, tack and feed rooms finished for traction and drainage. Built for horses and hoses.

Learn more →

Agricultural & Equipment Slabs

Equipment sheds, hay barns, feed and wash pads, and machinery floors for working farms and groves.

Learn more →

Monolithic House Slabs

Monolithic slab-on-grade foundations for new homes, ADUs, and additions, poured to the engineer's plan.

Learn more →

Metal Building & Pole Barn Companies

Need a slab crew you can count on? We pour to your drawings and your schedule.

Partner with us →

Get your Davenport barn pad priced

Call (863) 269-3083 or book your free site walk. We shoot the grade, read the barn plans and send the quote in writing.
